Release Notes

Release 8.9 - January, 2025

Enhancements

DTS-5391

Add a Restricted Activation Mode for high-security environments with no internet connection

Licensing

DTS-5249

As a DCR user, I’d like to be able to run simulations and fit distributions using DCR8 licenses

DCR (Previously PCR)

DTS-5252

As a DCR user, I’d like to be able to run optimizations using DCR8 licenses

DCR (Previously PCR)

DTS-5127

Upgrade .NET Framework from v4.6.1 to 4.8

@RISK / Evolver

Fixes

DTS-5352

Additional workbooks created with errors after optimizations with Multi-CPUs

@RISK

DTS-5385

When creating a correlation table between inputs, the name range was wrongly defined

@RISK

DTS-3001

Calculated cost is incorrect for FixedDuration type tasks where WorkContour value is not Flat

SRA

DTS-5274

Project custom fields containing formulas with baseline start or finish dates cause a crash during the import

SRA

DTS-5291

Incorrect duration when importing a Primavera file

SRA

DTS-5296

As Late As Possible constraint is not working as expected when % Compl. >0%, and the task is a successor

SRA

DTS-5297

As Late As Possible constraint is not working as expected with SF Relationships

SRA

DTS-5299

Start Date of tasks with % Complete > 0% are changing when using a Finish No Early Than constraint

SRA

DTS-5306

Incorrect Critical Path when using multiple successors

SRA

DTS-5321

Outputs in summary tasks are replaced by Inputs when copying and pasting tasks - ES Regional Settings

SRA

DTS-5387

Late Start and Late Finish are wrong when a task is 100% completed

SRA

DTS-5398

Start Date of tasks with % Complete > 0% are changing when the task has constraints

SRA

Release 8.8.1 - September, 2024

Fixes

DTS-5327

It is not possible to edit columns to the right in the SRA Model

SRA

Release 8.8.0 - September, 2024

Highlights

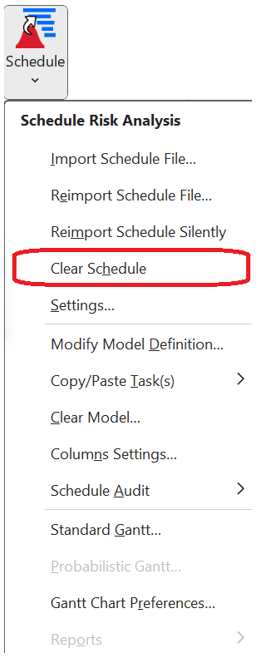

SRA – Replace and Clear SRA Model

These new SRA Clear Schedule and Replace features enable users to create reusable SRA model templates to import different projects.

The Clear Schedule functionality lets users remove all the imported schedule information from the workbook.

The Replace functionality improves the Import Schedule File. With this new version, the user can import a project file to the Active workbook even if it already has a defined SRA Model.

SRA will clear the original model and import the new one in a single action.

For both the Clear and Replace Schedule options, the SRA Model worksheet will keep the SRA Model table headers, user definitions in columns to the right, and additional worksheets the user defines. Users could import any project to this workbook and adapt their Excel definitions to the new project.

Security – XLA files converted to XLAM

@RISK and DTS XLA files were converted to XLAM, a preferred format due to its enhanced compatibility and support for newer Excel features. And most importantly, it provides a more structured, secure, and robust way to manage and distribute Excel add-ins. These are the new files installed with @RISK and DTS: Risk.xlam, RiskSimMultiCpu8.xlam, Ptree.xlam, StatTools.xlam and TopRank.xlam.

Enhancements

DTS-4970

SRA - Replace and Clear Imported Project

SRA

DTS-5071

Update FlexNet library v11.19.6.0

Licensing

DTS-5068

Convert XLA to XLAM (Except StatTools Analyses)

Installer/Security

DTS-5221

Add Cryptlex Entitlement ID and LicenseID to the Product Diagnostics Logs

Licensing

Fixes

DTS-5178

Not all tasks with a % Complete higher than zero have simulation results in the Finish Date.

SRA

DTS-5226

The successors column is displaying the Successors Unique ID instead of the ID.

SRA

DTS-5241

@RISK Excel Tool for Evolver not working

@RISK/Evolver

DTS-5267

Tasks with As Late As Possible constraint and 100% Complete wrongly impacting Finished Dates.

SRA

DTS-5276

RiskSplice is not displayed in the Define Distribution Window

@RISK

DTS-5304

Server Manager: Cryptlex service shows as running even if it is busy or the port is already used

Licensing

Release 8.7.0 - August, 2024

Highlights

Evolver has been updated with an improved user interface and experience, and up to 4 times faster optimizations.

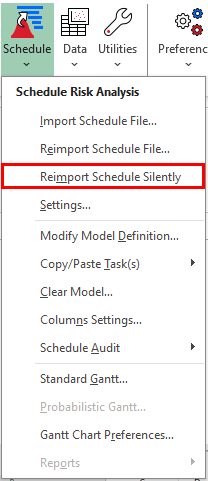

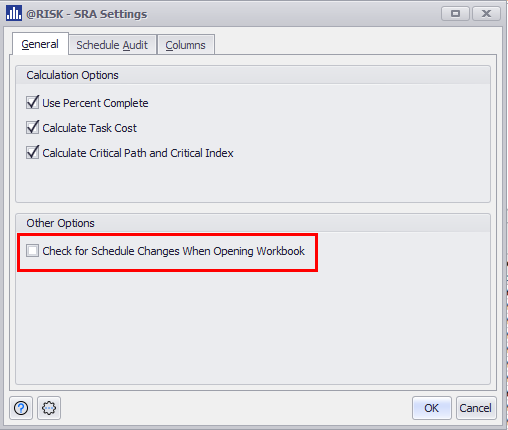

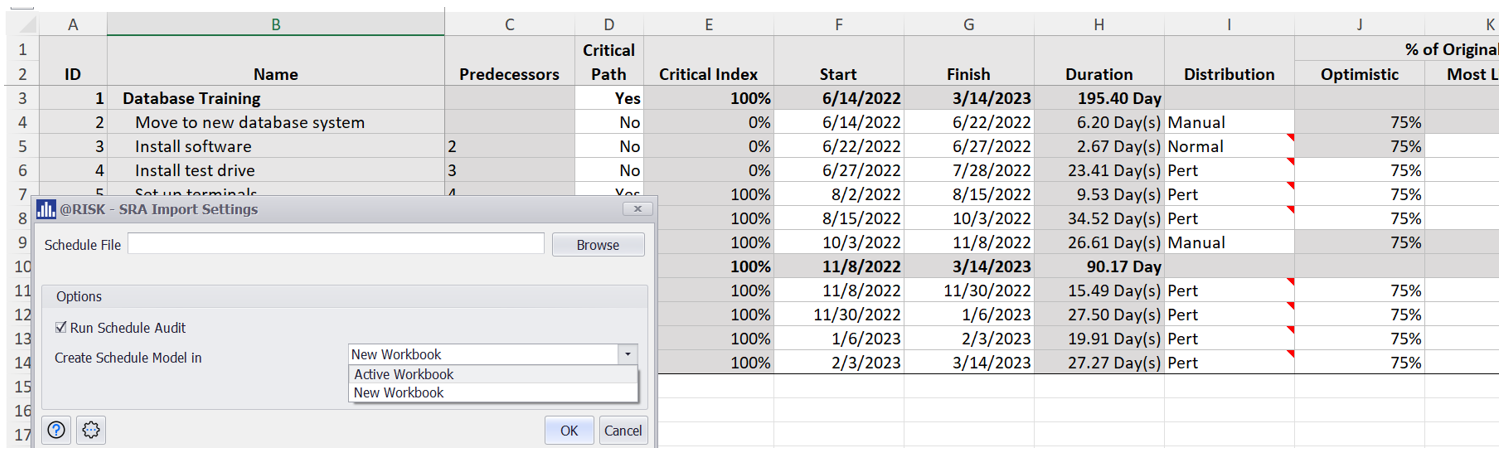

SRA – Silent Reimport

New option to reimport project silently to include any change made to the original project file. Setting to define if reimport is done every time the SRA model is opened.

SRA – Additional column fields

New project fields were added to the Column Setting Option.

MS Project field – Task Summary Name

Primavera P6 fields – Activity ID and Project ID

Enhancements

DTS-4759

SRA Silent Reimport

SRA

DTS-4962

As a user I want to be able to add Summary Task Name field to my SRA Model Columns

SRA

DTS-5090

As a user I want to be able to add Activity ID and Project ID fields to my SRA Model Columns

SRA

Fixes

DTS-4185

Different simulation results with RiskCompound with multi-CPU simulations with fixed seed for Non-EN Regional Settings (Swiss German, French, Spanish)

@RISK

DTS-4667

Function menu in the @RISK ribbon doesn't display all functions

@RISK

DTS-4712

Browse Window delimiters are not correctly displayed with right-click menu option

@RISK

DTS-4983

Different simulation results for cells with RiskGamma running single-CPU and fixed seed

@RISK

DTS-5026

The tornado graph is not displayed in the @RISK Compact Report when there are more than 12 inputs

@RISK

DTS-5073

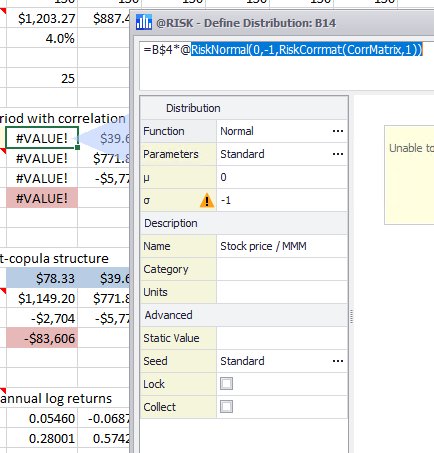

@RISK error occurs when editing a Correlation Matrix after a Time Series batch fit

@RISK

DTS-5093

Excel crash when opening @RISK in a virtual environment

@RISK

DTS-5169

Cannot rename worksheet for @RISK models

@RISK

DTS-5089

P6 (XER) file with links to other projects is not correctly imported into SRA

SRA

DTS-5017

After reimporting a project, simulation results were still available from the original project

SRA

DTS-5025

SRA Probabilistic Report error when saving simulation results directly in the workbook

SRA

DTS-5036

The schedule is updated in the Model worksheet despite canceling the reimport

SRA

Release 8.6.1 - May, 2024

Fixes

DTS-4185

Different simulation results with riskcompound() with multi-CPU simulations with fixed seed for Non-EN Regional Settings (Swiss German, French, Spanish)

@RISK

DTS-4667

Function menu in the @RISK ribbon doesn't display all functions

@RISK

DTS-4983

Different simulation results for cells with riskgamma() running single-CPU and fixed seed

@RISK

DTS-5026

The tornado graph is not displayed in the @RISK Compact Report when there are more than 12 inputs

@RISK

DTS-5017

After reimporting a project, simulation results were still available from the original project

SRA

DTS-5025

SRA Probabilistic Report error when saving simulation results directly in the workbook

SRA

DTS-5036

The schedule is updated in the Model worksheet despite canceling the re-import

SRA

DTS-4454

Payoff Calculation Method - VBA Macro is returning errors when using non-code-page character in the file name and model worksheet

PrecisionTree

Release 8.6.0 - March, 2024

Highlights

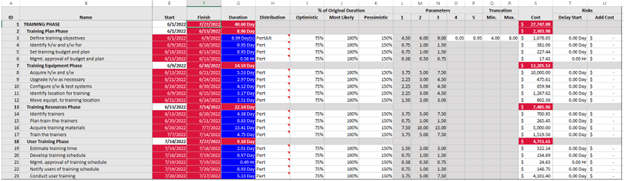

SRA – Simulation supports Multiple Task Calendars

SRA simulation now supports Projects with Multiple Tasks Calendars. When you define multiple Task Calendars in your project and assign them to specific tasks, SRA simulation will now consider their corresponding Working Times to calculate each iteration's Start and End Date.

Using the Column Settings function, you can add the Task Calendar column to your SRA Model and have a reference of the calendar used in each task.

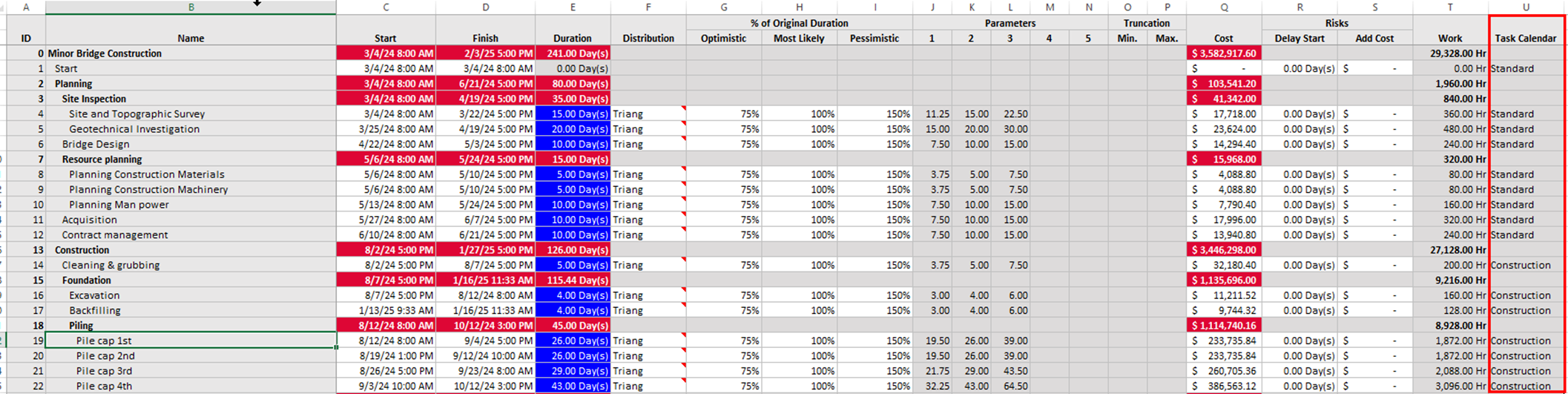

Please review our new example model for SRA – Multiple Task Calendars. You can find it in the @RISK Example Menu > Schedule.

Trial licenses supported by the new Company Licensing System

Lumivero is in the process of phased transition of the @RISK/DecisionTools Suite licenses to a new licensing solution for improved user experience. Your license is described in the License Manager as a "Legacy" license. All legacy licenses belong to the older licensing system; however, they are fully functional, and no action is required from you at this release.

The new Lumivero licensing system now supports all new @RISK/DecisionTools Suite Trial licenses.

Enhancements

DTS-4416

SRA – Simulation supports Multiple Task Calendars

SRA

DTS-4088

Remove Microsoft's Microsoft Foundation Classes (MFC) dependencies

@RISK

DTS-4316

Trial licenses supported by a new Company Licensing System

Licensing

Fixes

DTS-4307

The Start Date of the Project Summary Task does not change when using delays

SRA

DTS-4374

#REF! error after removing all @RISK functions from the SRA Model with Critical Path column before the inputs and outputs columns

SRA

DTS-4703

Multiple As Late As Possible Constraints are not working correctly

SRA

DTS-4384

Gantt chart export preview is updated each time a custom date control loses its focus

SRA

DTS-4457

Unable to draw graph in Distribution Artist

@RISK

DTS-4801

Unable to install @RISK because of Registry Key security policy limitations in Windows Enterprise

Installer

DTS-4830

InstallShield CVE-2021-41526 Vulnerability within @RISK

Installer

Release 8.5.2 - October, 2023

Enhancements

DTS-4446

Convert NeuralTools.XLA to NeuralTools.XLAM for better Antivirus support

NeuralTools

DTS-4607

New Lumivero's Master License and Service Agreement

Licensing

Fixes

DTS-4457

Unable to draw graph in Distribution Artist

@RISK

DTS-4374

#REF! error after removing all @RISK functions from SRA Model with Critical Path column before the inputs and outputs columns

SRA

DTS-4453

Files are not removed from Palisade/System folder during uninstall

Installer

Release 8.5.0 - July, 2023

Highlights

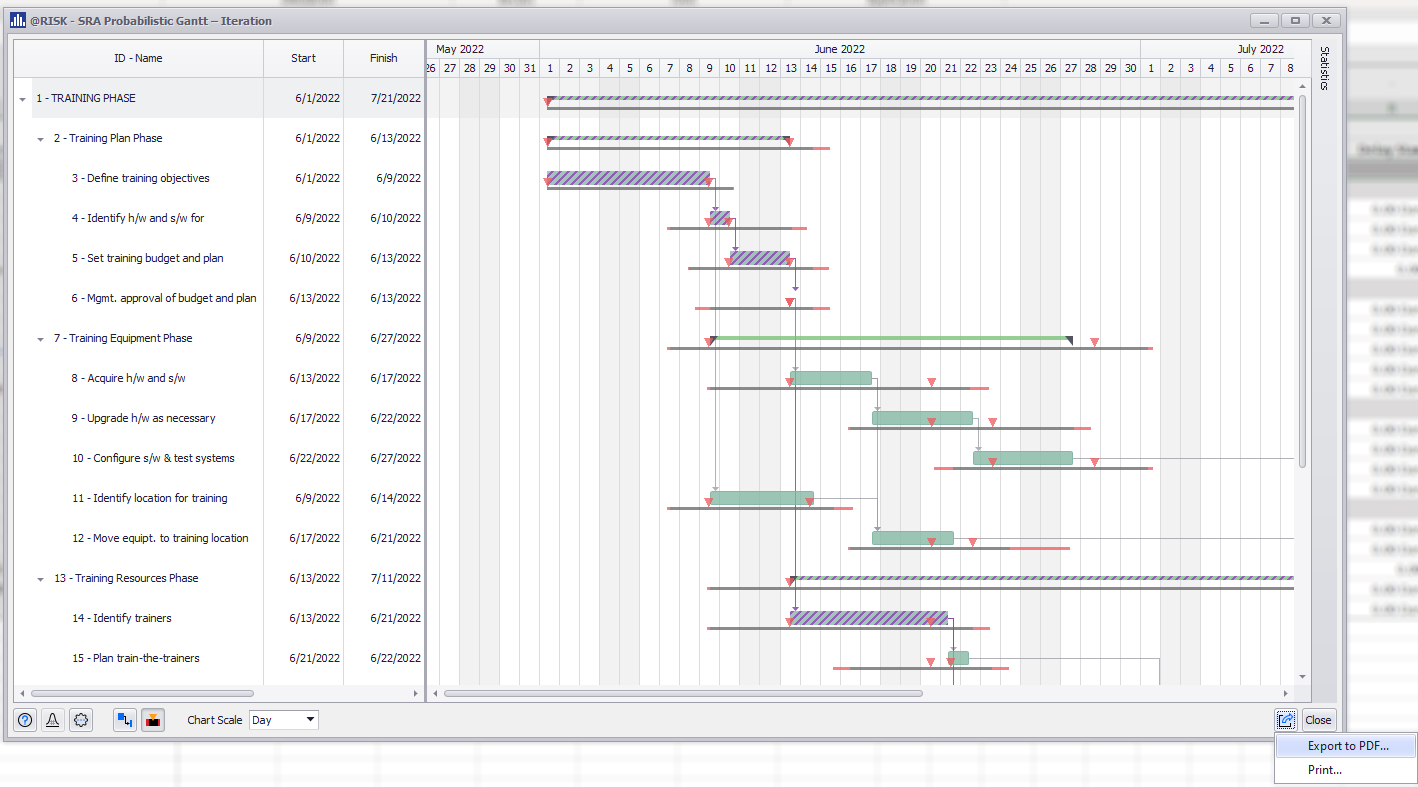

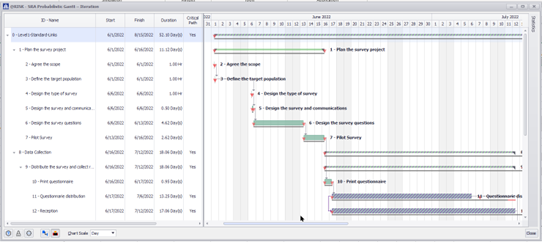

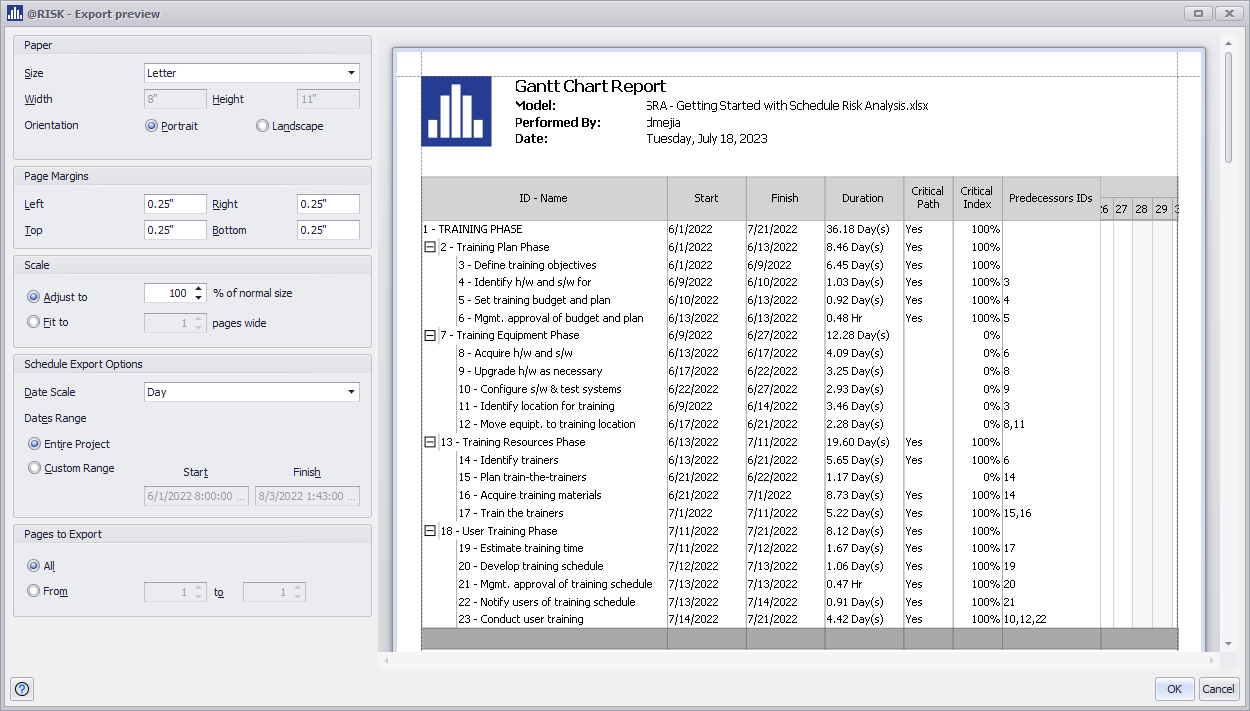

SRA: Export and Print Gantt Charts

This new feature to export to PDF and print SRA Gantt Charts enables customization of Standard and Probabilistic Gantt Chart exports, including project dates, scales, and industry standards like paper sizes, page margins, orientation, and scale.

Synchronize time series at any point of historical data.

The Time Series Synchronization function now supports synchronizing forecasts to Define and Fit Time Series at any historical data point.

Display horizontal markers next to the curve in Cumulative Distribution Graphs.

New, improved visualization for Markers in Cumulative Distribution Curves. For graphs with a single cumulative curve, markers are now horizontal by default, pointing precisely to the selected value.

Enhancements

DTS-3929

SRA - New feature to Export and Print Deterministic and Probabilistic Gantt Charts

SRA

DTS-654

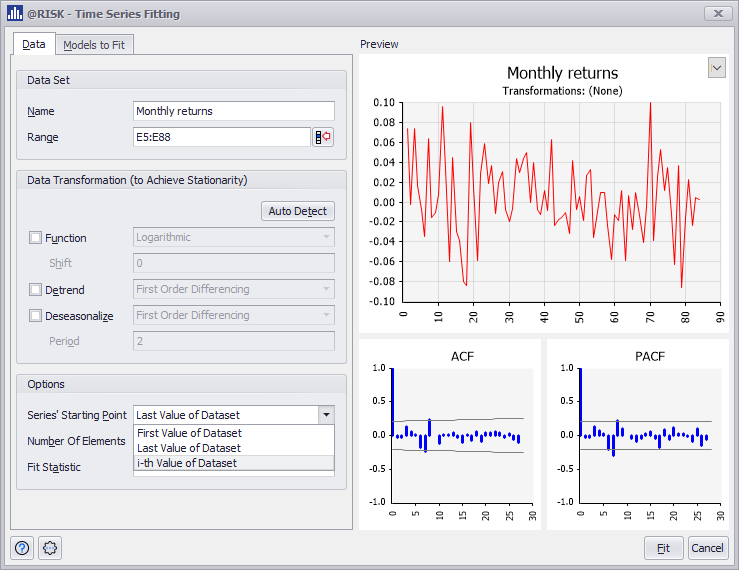

New option to synchronize Time Series Definition and Fitting at any point of historical data

@RISK

DTS-1034

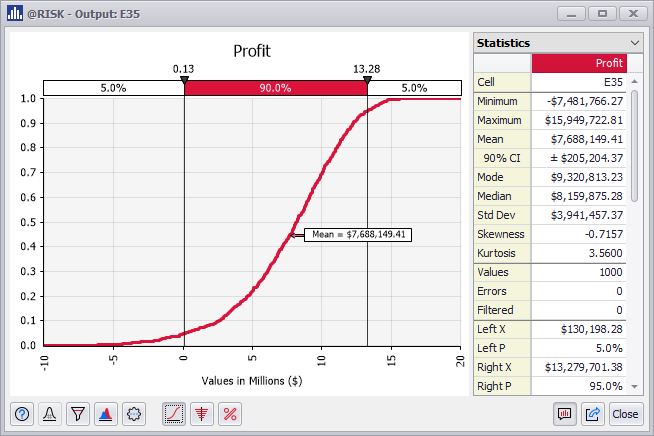

Display horizontal markers next to Cumulative Distribution curves

@RISK

DTS-929

RiskResultsGraph now supports @RISK models cells that are neither inputs nor outputs

@RISK

Fixes

DTS-4309

List to select Duration Distributions in SRA Model Worksheet not working with Non-English Regional Settings

SRA

DTS-4353

@RISK crashes when importing a P6 project with out-of-sequence tasks

SRA

Release 8.4.1 - June, 2023

Enhancements

DTS-4296

Update Aspose.Tasks to .NET 23.5

SRA

Fixes

DTS-4263

Unable to import P6 Project into SRA because of TimeSpan error

SRA

DTS-4297

SRA Model is not recalculating when switching to Static mode

SRA

DTS-4216

@RISK ribbon loses focus when a second SRA project is imported

SRA

DTS-4235

Error message when changing graphing preferences

@RISK

DTS-4218

#VALUE! error when creating a Tree from an Influence Diagram with English Regional Settings

PrecisionTree

Release 8.4.0 - April, 2023

Highlights

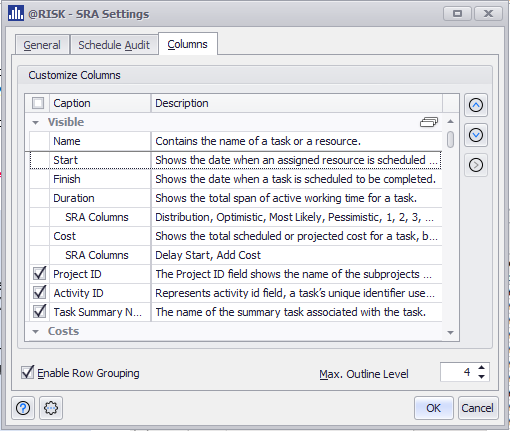

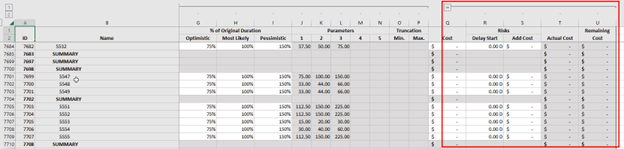

SRA: Add more Project field columns in the Model worksheet.

New feature to include additional MS Project or Primavera project fields to the Model worksheet as reference columns. Fields can be selected and arranged in the Columns tab of the SRA Settings dialog.

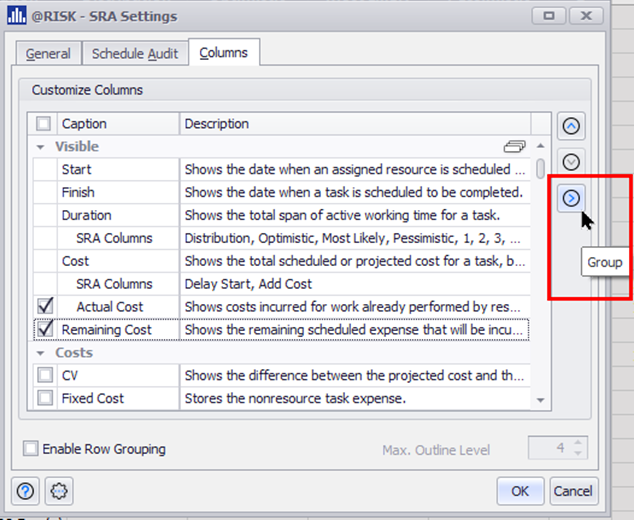

SRA: Group columns and rows in the SRA Model

The Column Settings tab also has two new options to group Model rows and columns:

  • Select one or more additional columns to group them as part of an existent group or with the previous column in the Columns Settings Tab.

  • Easily group Model Worksheet rows up to eight levels of task's Outline level.

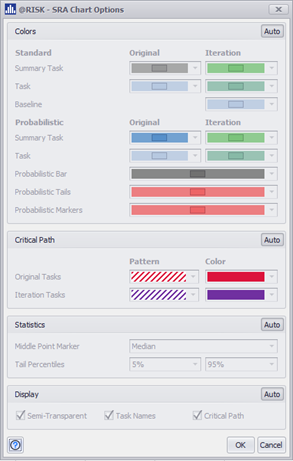

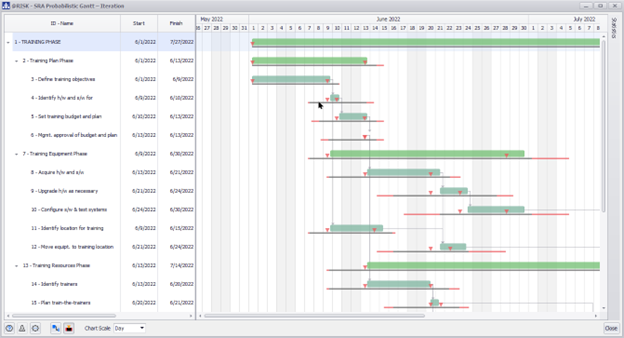

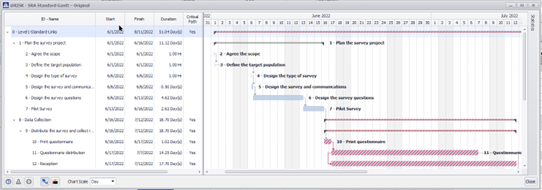

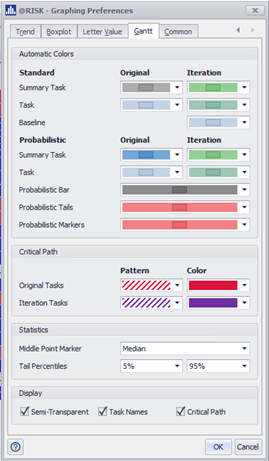

SRA: Visualize Critical Path in Gantt Charts

Original and Iteration Critical Path Tasks are now formatted in the Standard and Probabilistic Gantt Chart Views.

Customize the format in the Graphing Preferences for all models and Chart Options for the specific model Gantts.

SRA: Inactive tasks considered in the project schedule simulation

SRA schedule simulation was improved to consider inactive tasks previously defined in MS Project or Primavera. Inactive tasks now have a different format in the Model Worksheet, Gantt Chart, and SRA Reports.

Enhancements

DTS-3113

Support long simulation names in Summary Trend Graphs for Multiple Simulations

@RISK

DTS-3955

New option to group Outputs by Default Ranges in the Model List and Results Summary

@RISK

DTS-3957

New option to remove one or more cells from an Output Range

@RISK

DTS-3880

Updated OptQuest version

Risk

Optimizer

DTS-927

Support Optimizations for protected sheets with password

Risk

Optimizer

DTS-3693

New option to add more Project field columns in the Model worksheet

SRA

DTS-4073

Warning about Critical Path and Cost Calculation Settings before Simulation starts

SRA

DTS-3797

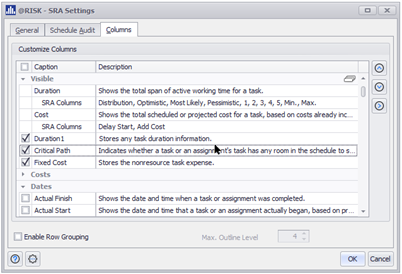

New SRA Settings dialog

SRA

DTS-3922

Additional project fields displayed in the Reimport Change Log

SRA

DTS-3893

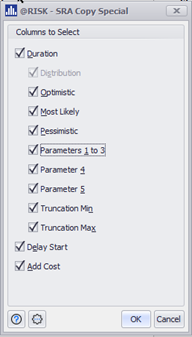

New Copy Special feature to Copy-Paste model definitions across locked cells

SRA

DTS-3937

Visualize Original and Iteration Critical Path Tasks in the Standard and Probabilistic Gantt Chart Views

SRA

DTS-3934

Customize Options and Preferences for Critical Path format

SRA

DTS-4005

Inactive tasks considered in the schedule simulation

SRA

DTS-4006

Formatting Inactive Task in Model Worksheet and Gantt Charts

SRA

DTS-3966

Early and Late Dates and Critical Path fields now can be defined as Outputs when displayed in the Model Worksheet

SRA

DTS-4049

New option to group columns and rows in the SRA Model

SRA

DTS-4002

New format for Summary Tasks in the Gantt chart window

SRA

DTS-3858

Copy Statistics Data from the selected task in Gantt Charts

SRA

DTS-3661

Optimized processes to create Chart-in-Excel

@RISK

DTS-3878

Disable the AddMulti method in StatTools XDK

StatTools

DTS-2900

Local Help deprecated from @RISK and Evolver

Documentation, @RISK, Evolver

Fixes

DTS-1559

Some numbers are stored as text when Input Reports are written in Excel

@RISK

DTS-2980

Browse Results doesn't update to another cell during simulation

@RISK

DTS-3205

Delayed recalculation or duplicated recalculation in the iteration step mode

@RISK

DTS-3370

Exception when Browse Results window is restored during simulation start

@RISK

DTS-3581

Linked-fitted distribution does not include RiskFit when written over another distribution

@RISK

DTS-3831

Graphing Options Axis Scale does not allow to enter percentage values

@RISK

DTS-3857

Bad list separator in RiskOptimizer Constraint Definition dialog with Spanish regional settings

@RISK

DTS-2367

Results Summary window is not shown during the optimization process

@RISK

DTS-3785

RiskOptimizer - Incorrect format in the Result Column of Log reports

@RISK

DTS-3887

XDK optimization example gives Compile error

@RISK

DTS-2702

Cannot launch DTS Tools from the desktop icon when you launch @RISK as an administrator

@RISK

DTS-3286

Run time error displayed in @RISK upon uninstalling Server Manager

@RISK, Server Manager

DTS-3945

Silent installation doesn't install @RISK in Spanish

@RISK, Installer

DTS-3841

PrecisionTree and @RISK options are not working as expected in Step Mode

Precision

Tree

Release 8.3.3 - February, 2023

Fixes

DTS-3895 Wrong Values in X-axis for Regression Mapped Tornados for SRA Outputs with Date format @RISK - SRA
DTS-3923 RISKOptimizer "Performing end-of-optimization tasks..." message missing @RISK
DTS-3956 Simulation failed because the workbook name has a single quote and was not allowed @RISK
DTS-3869 It is not possible to select Extended Trial licenses from @RISK License Manager Licensing @RISK

Release 8.3.2 - November, 2022

Highlights

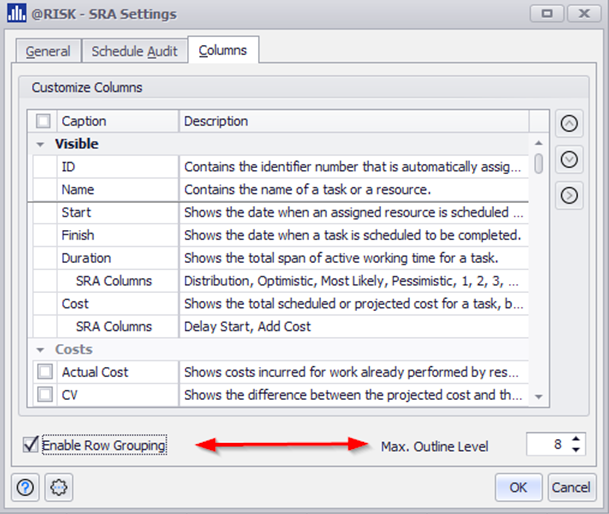

@RISK: ScheduleRiskAnalysis

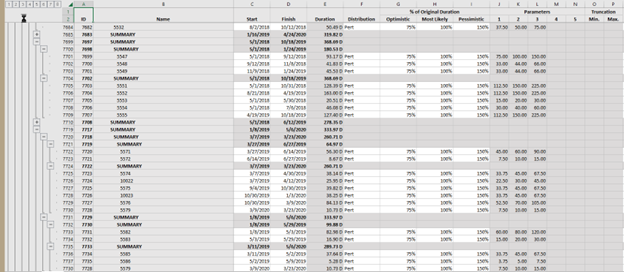

The new @RISK ScheduleRiskAnalysis allows you to define schedule risk models in Excel for project files created in Primavera P6 or Microsoft Project, by applying all the power and flexibility of @RISK Monte Carlo simulation.

  • Import and reimport project files to Excel

  • Add inputs to tasks durations and outputs to project fields you want to analyze

  • Link tasks to risk events to add delays and costs.

  • Analyze Schedule Risk Results with Standard and Probabilistic Gantt Charts

@RISK: New RISKOptimizer User Interface

The @RISK RISKOptimizer feature has been updated with an improved user interface and experience, and faster optimizations with 64-bit Excel.

@RISK: New Stress Analysis User Interface

The @RISK Stress Analysis feature has been updated with an improved user interface and experience.

Evolver: New Online Documentation

Evolver documentation is now online. All Evolver dialogs will now access the corresponding online page.

Please Note: Spanish documentation was partially completed as of the release date. The product will automatically start delivering Spanish documentation content as soon as it becomes available online.

Enhancements

DTS-482 New RISKOptimizer User Interface @RISK
  New Stress Analysis User Interface @RISK

DTS-2170 Support running simulations with @RISK models with correlation matrix and protected workbooks @RISK
DTS-2393 New Read-Only mode for the Define Distribution Window allows visualizing distribution graphs, statistics, and parameters when the source cell is protected @RISK
DTS-3477 New ScheduleRiskAnalysis for @RISK @RISK
DTS-2580 Evolver Online Help Documentation Evolver
DTS-2546 Support TopRank models with correlation matrix and protected workbooks TopRank

Fixes

DTS-1983 Incorrect graph when RiskLock is on a Frequency Distribution for RiskCompound @RISK
DTS-2168 Unable to create a template report from a protected workbook @RISK
DTS-2169 Error message when exporting a chart in Excel from a protected workbook @RISK
DTS-2240 Excel crashes when creating Advanced Sensitivity Analysis Reports when tracking the Standard Deviation @RISK
DTS-2385 Export report for Data Window has columns mixed between worksheets inputs/outputs @RISK
DTS-2595 Lognormalt with RiskTruncate2 is giving an error @RISK
DTS-2600 Improved Error Message when running a Solver model with unknown errors and @RISK @RISK
DTS-2608 Simulation won't run if a column name in a table starts with the @ character @RISK
DTS-2785 Cannot open Distribution Artist when active cell is a date @RISK
DTS-2879 Browse results window only shows one output graph regardless of which output is selected @RISK
DTS-3186 Fitting Discrete Sample Data: Error Message when scrolling down Statistical Summary @RISK
DTS-3199 Enable correct available ranking methods in the Fitting dialog for Discrete Sample Data @RISK
DTS-3617 Advanced Sensitivity Analysis Input Graphs are empty when Output and Input are Dates @RISK
DTS-3641 Scatter Plots are not shown in the Define Copula Window with Spanish Regional Settings @RISK
DTS-3181 Suspicious Binary Detected by Antivirus is now whitelisted DTS
DTS-2871 Evolver progress window doesn't go away after canceling optimization Evolver
DTS-3028 Hypothesis Test for Mean/Std. Deviation with Paired-Sample Analysis and Summary Statistics as Input Data returns Runtime Error StatTools
DTS-2551 Error when opening files with Macros and Concurrent Licenses Licensing @RISK

Release 8.2.2 - March, 2022

Fixes

DTS-2784 Unable to visualize the Probability Density graph for Burr12 due to X-Axis scaling @RISK
DTS-2795 Error message when adding an output to cells with Excel Names starting with the word "True" @RISK
DTS-2604 Unable to select network licenses when there are two license servers running Licensing
DTS-2633 Unable to select network licenses because the server is not replying to client messages Licensing

Release 8.2.1 - December, 2021

Highlights

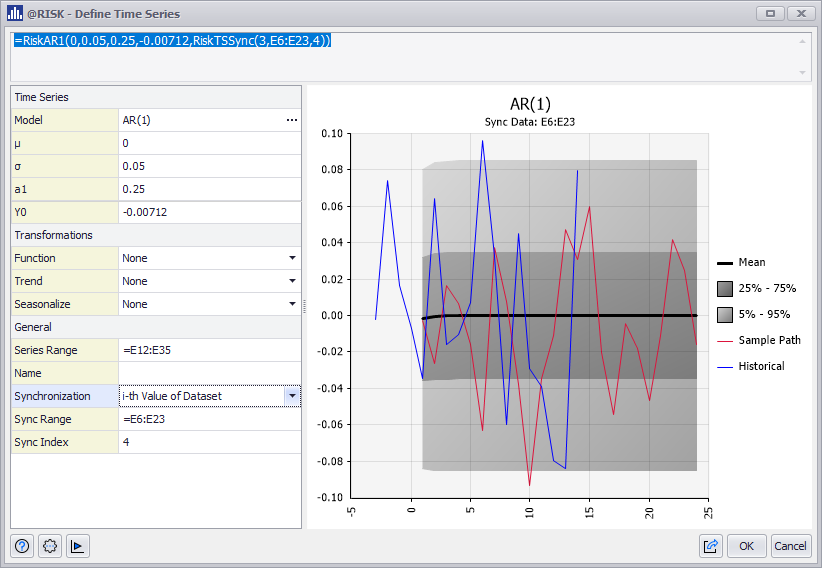

@RISK: Time Series Fitting Increased Range Limits

The number of data points that can be used in Time Series Fitting has been significantly increased; longer time series data - up to a million data points - can now be used effectively, though the fitting process may still take significantly longer with larger data sets.

Additionally, the historical graph in Time Series graphs will only display 2000 data points, no matter how large a data series is used.

Please note: @RISK will no longer try to prevent Time Series Fitting with any data series, but larger data sets may cause "out of memory" errors and other unexpected behavior.

Enhancements

DTS-2433 Time Series Fitting Increased Range Limits @RISK

Fixes

DTS-2105 Hidden Sheet data overwrites existing model worksheet @RISK
DTS-2184 Negative Values for the omega parameter of an EGARCH model return errors @RISK
DTS-2248 Creating reports with tracking statistic of Standard Deviation crashes Excel @RISK
DTS-2273 @RISK crashes when defining new Time Series with transformations @RISK
DTS-2330 Browse Results Window does not display graph after changing number of simulations @RISK
DTS-2354 Model List closes when trying to open Define Distribution Window when a function includes incorrect arguments @RISK
DTS-2379 Valid Time Series fit returns #VALUE! error when writing to Excel @RISK
DTS-2413 Input names in Tornado graphs don't display when RiskName references Excel Table Headers @RISK
DTS-2416 Chinese characters in workbook name prevent multiple CPU simulations from running @RISK
DTS-2577 Running multiple CPU simulations causes exception errors @RISK
DTS-2583 Input Report Setup does not update group option when a Time Series Report is selected @RISK
DTS-2603 Detailed Statistics Report is generated even when no simulation data exists @RISK
DTS-2609 Opening a swapped-out file closes Excel @RISK
DTS-2182 Data Viewer - Chart in Excel option does not work NeuralTools, StatTools

Release 8.2 - July, 2021

Highlights

@RISK: Dynamic Array Functions

Six new @RISK formulas allow you to create Excel dynamic arrays with @RISK simulation data, results are returned in a dynamic array of whatever size is necessary to hold the values:

  • RiskDataDA: returns the simulated data value(s) of simulation.
  • RiskSensitivityDA: returns the sensitivity analysis information of simulated output.
  • RiskSensitivityStatChangeDA: returns the “change in output statistic” sensitivity analysis information of the simulated output.
  • RiskFitParametersDA: returns the values for the parameters of the best fitting distribution from the fit performed by the RiskFitDistribution.
  • RiskFitStatisticsDA: returns the statistics from the fit performed by the RiskFitDistribution.
  • RiskCorrectCorrmatDA: returns a corrected correlation matrix.
  • RiskSimulationInfoDA: returns all simulation information options in one dynamic array.

This functionality only works on Office 365 with Excel Dynamic arrays.

See these online examples to see how @RISKDataDA and @RISKSensitivityDA can be used to create dynamic Excel Charts:

Dynamic Arrays - RiskDataDA with an LDA Base Model

Dynamic Arrays - RiskSensitivityDA with a New Product Development Base Model

@RISK: Error Handling with Debugging Messaging

There is a new Error handling functionality that will identify misconfigured or incorrect @RISK elements, including distribution functions, outputs, and @RISK statistic functions.

This release includes the following Error Handling:

Distribution Functions error warnings and explanations are included in the Define Distribution, Model List, and the Results Summary Windows and can be seen by hovering over the icon.

Figure 1 - Distribution Function Error Warning

All @RISK functions with error warnings can be filtered in the Model List and the Results Summary Windows using the new Issue View button ( ).

Details of the error from a cell with a Distribution Function can be viewed in the Excel status bar at the bottom of the Excel window.

Output and Statistical Function errors resulting from their precedent distribution functions with errors are included in the Results Summary Windows and can be seen by hovering over the icon.

@RISK: Added Letter Value Graphs

The Letter Value graph is a new Summary Graph that takes a Box Plot Graph to the next level! It graphs the spread with a variable number of letter value boxes. You will be able to visualize better estimates further out into the tails and reduced number of “outliers” displayed for large data sets.

Figure 2 - Summary Letter Value Graph

See this online example to see how this new graph is used in a Operational Risk model:

Letter Value Graph - Letter Value Graph with an LDA Base Model

@RISK: Select from Multiple Sheets When Creating Scatter Plots

The dialog to create Scatter Plot Graphs has been updated to allow selecting inputs and outputs from multiple worksheets.

Figure 3 - Scatter Plot - Select Axis Window

@RISK: Swap Overlayed Distributions

The Define Distribution window now allows for swapping overlay distributions with the original distribution, replacing the original @RISK function with the overlay's @RISK function. This enables quick comparison of input definitions and quick selection of the distribution that is most appropriate to the model.

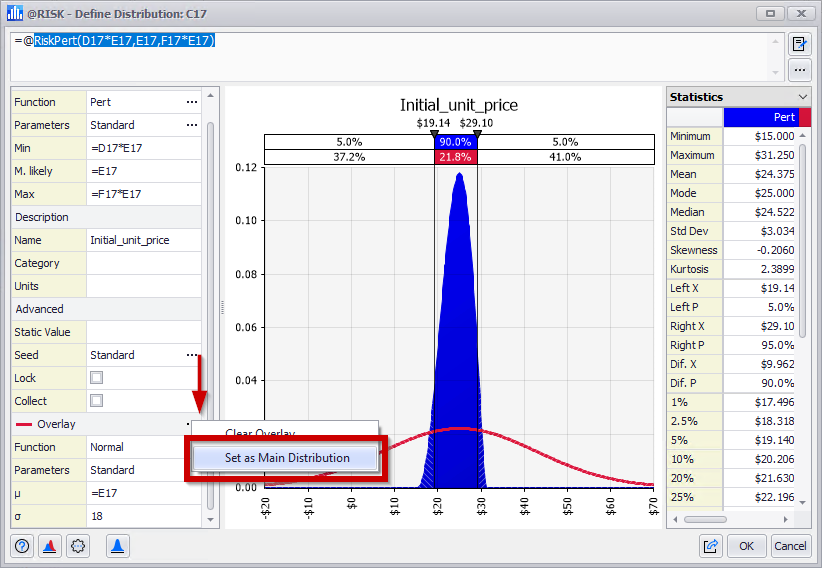

Figure 4 - Define Distribution - Swap Overlay

@RISK: Export Simulation Data from Graph Windows

The Browse Results, Scatter Plot, and Summary Graphs Windows now have the option to Export or Copy the Simulation Data for the displayed inputs or outputs.

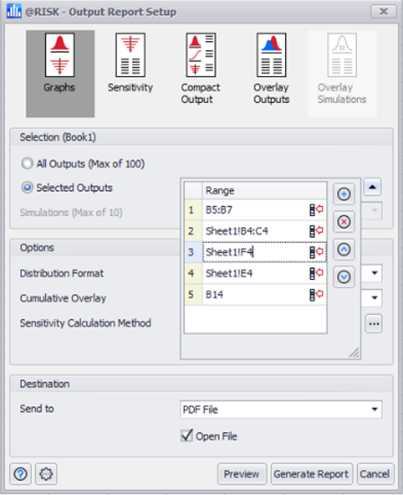

@RISK: Simulation Data Report

The new Simulation Data Report now allows for the selection of inputs and/or outputs to generate a report with their Simulation Data in an Excel Worksheet.

@RISK: Input/Output Thumbnails in Data Window

Thumbnail graphs for inputs and outpus are now included in the Data Window, aiding in the interpretation of simulation results.

@RISK: Sampling Type and Generator Added to RiskSimulationInfo

Two new arguments have been added to the @RISK function RiskSimulationInfo; these will display the Sampling Type and Generator used during the simulation.

@RISK: New Advanced Sensitivity Analysis User Interface

The @RISK Advanced Sensitivity Analysis feature has been updated with an improved user interface and experience.

@RISK: New License Manager User Interface

The @RISK License Manager feature has been updated with an improved user interface and experience.

@RISK: New Software Update User Interface

The @RISK Software Update feature has been updated with an improved user interface and experience.

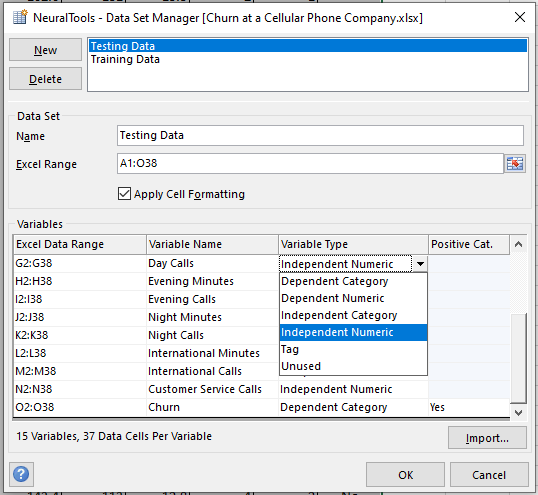

NeuralTools: Updated Warnings

Now when testing or predicting PN/GRN nets there are also warnings for the number of test and prediction cases whose values are not between the minimum and maximum of the corresponding training variables. These warnings can be found in the Preview dialogs, Reports and as a note in the Live Prediction cell for numeric independent variables.

Enhancements

DTS-1675 SmartSensitivity Analysis works with Excel LAMBDA functions DecisionTools Suite
DTS-303 Letter Value Graph added to Summary Graphs group and views @RISK
DTS-392 Error handling with useful debugging information across the user interface @RISK
DTS-402 @RISK Dynamic Array Functions @RISK
DTS-483 New License Manager User Interface @RISK
DTS-485 New Software Update User Interface @RISK
DTS-644 Sampling Type and Generator added to RiskSimulationInfo @RISK
DTS-1009 Export Simulation Data from Graph Windows @RISK
DTS-1032 Select one of the overlayed distributions to replace the original one @RISK
DTS-1236 Select inputs/outputs from multiple sheets when creating a Scatter Plot @RISK
DTS-1240 New Advanced Sensitivity Analysis User Interface @RISK
DTS-1320 Simulation Data Report @RISK
DTS-374 Warnings for cases outside the range of training data NeuralTools

Fixes

DTS-124 Registry Key is inaccessible if the first run of the product after install is under an Admin Account but subsequent runs are not @RISK
DTS-1470 RiskSimulationInfo function is showing #N/A when opening a file with simulation data saved in it @RISK
DTS-1628 Macro file in XLSTART directory prevents multiple CPUs from being used @RISK
DTS-1747 Adding RiskVary overlay in Define Distribution window doesn't make use of parameters of underlying distribution @RISK
DTS-1799 RISKOptimizer models with correlations matrices can cause Excel to crash when running with multiple CPU @RISK
DTS-1957 RiskCumul showing different results for Standard Deviation between @RISK versions @RISK
DTS-1970 Models with linked fits crashed on Windows 7 @RISK
DTS-1988 Saving an @RISK model workbook is not possible after deleting some columns with distributions functions @RISK
DTS-2035 Excel crashes with multiple CPU simulations @RISK
DTS-2110 Error when generating a Sensitivity Scatters Report in active workbook @RISK
DTS-2113 The XDK CreateScenarioReport method crashes Excel @RISK
DTS-1369 Cancelling prompt during uninstall doesn't stop the process if there's a borrowed license Installer
DTS-1704 Repair option is not working Server Manager Licensing
DTS-1763 Add missing Spanish example files so they can be accessed from the Examples worksheet NeuralTools
DTS-1832 Validation error on a non-active tab in Model Settings Dialog doesn't change tab to highlight error PrecisionTree
DTS-1992 Error message when defining input ranges in Sensitivity Analysis PrecisionTree
DTS-1715 TopRank analysis may crash if @RISK also loaded and displaying Browse Results Window TopRank

Release 8.1.1 - March, 2021

Enhancements

DTS-301 Installation now requires EULA approval Installer
DTS-501 Updated licensing components to use FlexNet version 11.18 Installer
DTS-877 StatTools and TopRank Spanish local documentation now available Documentation

Fixes

DTS-1760 Addin Launcher sometimes gets stuck at "Initializing Microsoft Excel..." DecisionTools Suite
DTS-1381 Dynamic Arrays compatibility problem when running a simulation with linked fit @RISK
DTS-1478 Filter definitions cleared after disabling All Filters and running a simulation @RISK
DTS-1512 Uncolored Tornado bar when baseline value is not within the bar values @RISK
DTS-1531 Progress Window incorrectly shows Multiple CPU recommendation when running a Goal Seek simulation @RISK
DTS-1547 Clear Filter option in the Single Filter dialog not working properly @RISK
DTS-1553 Define Distribution Window graph customization not saved properly @RISK
DTS-1604 Goal Seek can experience poor performance during simulation start @RISK
DTS-1631 Error in Define Correlation Matrix when active cell contains special characters @RISK
DTS-1707 Graph customization lost when Excel file loaded before @RISK is started @RISK
DTS-1741 Distribution fits with input data filters not working correctly in all cases @RISK
DTS-1475 Linear Prediction does not work in the 8.1.0 release NeuralTools
DTS-1499 Number of Trials in the Summary Report is always zero NeuralTools

Release 8.1 - November, 2020

Highlights

All Products: Spanish Translation

The user interface for all the version 8.0 add-ins in the DecisionTools Suite have been translated into Spanish.

While the user interface and example files have all be localized into Spanish, unfortunately the Spanish product documentation was not completed as of the release date. Only the Evolver, PrecisionTree, and NeuralTools documentation is available in this release. If you are using @RISK’s online help system, the product will automatically start delivering Spanish documentation content as soon as it becomes available. If you are using the local help system of @RISK or the other products, you will need to update your software to get the translated documentation.

@RISK: Disable All Correlations During Simulations

There is a new Simulation Setting on the Sampling Tab (Figure 5, below) to disable all the correlations defined in your model. A shortcut for this setting can also be found in the Correlation Menu (Figure 6, below).

Figure 5 - Sampling Settings

Figure 6 - Correlation Menu

@RISK: Identify and Graph Outliers in Box Plots

Box Plots on the Summary Window or Data Viewer Window can now display outliers. This can be customized for an individual graph from the Graph Options dialog, or for all graphs from within @RISK’s Graphing Preferences dialog.

@RISK: Calculate Joint Probabilities Using New Statistic Functions

Two new @RISK statistic formulas allow you to calculate joint probabilities for two or more simulated input or outputs.

  • RiskJointProb2Dim calculates the fraction of iterations where a two simulated outputs or inputs fall in a given quadrant. (This matches the results shown by the delimiters in an @RISK scatter graph.)

  • RiskJointProbMultiDim calculates the fraction of iterations where any number of outputs or inputs meet a given set of range conditions.

@RISK: Select Report Outputs and Inputs across Multiple Worksheets

This new feature allows you to select multiple Excel ranges from different worksheets in the same workbook (Figure 7, below). You can also delete specific ranges, or change the order of how they will be displayed in your report.

Figure 7 - Output Report Configuration

@RISK: Choose and Order Results in Summary Graphs

The Summary Trend and Box Plot graphs now have a Summary Graph Manager that allows you to add, remove, and order the inputs and outputs shown in the graph. You can find it in the Settings/Actions menu of the Summary Graph Window.

@RISK: Model List Status Column Helps Identify Locked Inputs

The Model List Window (Figure 8, below) and Results Summary Window (Figure 9, below) now include a status column to visually show when an input is locked. From the Model List, you can lock and unlock inputs from the Edit menu or right-click context menu.

Figure 8 - Model List with Locked Inputs

Figure 9 - Results Summary with Locked Inputs

@RISK: Configure Two-Color Tornados

The Change in Output Statistic Tornado now allows the customization the two colors of the bars, so you can better differentiate between high and low inputs. The colors can be controlled for an individual graph using the Graph Options dialog. To control the colors for all new graphs, go to the Graphing Preferences dialog.

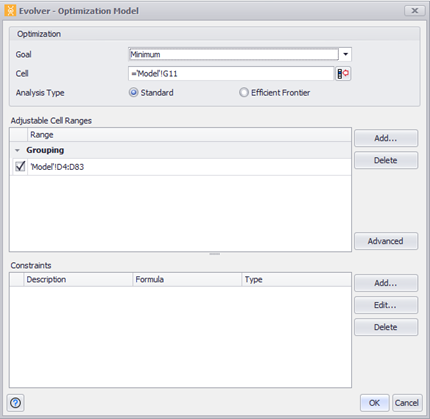

RiskOptimizer Graph to Compare Original vs Optimized Distribution

The Browse Results Window now allows you to compare the original distribution to the optimized distribution found by RISKOptimizer.

@RISK: New Dynamic Welcome Screen Content

Find the latest news from Palisade and @RISK in the new dynamic Welcome Screen. If you prefer to disable the Welcome Screen at startup, we’ll put notifications on the @RISK menu whenever there is new content available.

@RISK: Increased Report Limits

Summary and Detailed Statistics report tables can now include up to 500 inputs or outputs.

@RISK: New Goal Seek User Interface

The @RISK Goal Seek feature has been updated with an improved user interface and experience.

@RISK: Better Display Scaling

This version of @RISK has improved handling of different display scales (also known as DPI scales) in its windows, graphs, and reports.

@RISK: Add Property Functions from the Insert Menu

The ability to add Property Functions to your @RISK functions using the Insert Menu has been restored to @RISK version 8.

@RISK: Reference Overlays on Non-Active Sheets in the Define Distribution Window.

The option to overlay a distribution from an Excel range in the Define Distribution Window now supports selecting Excel cells from a non-active sheet.

NeuralTools: New Classification Performance Measures Report

For binary classification problems, one of the values in the dependent variable can now be defined as the “Positive Category”. With this designation we can present the testing results in terms of True/False Positives or Negatives; as well as reporting Accuracy, Precision, Recall, and F1 Score for the neural net’s performance.

Enhancements

DTS-63 Choose and Order Results in Summary Graphs @RISK
DTS-64 Reference Overlays on Non-Active Sheets in the Define Distribution Window @RISK
DTS-142 Better Display Scaling @RISK
DTS-201 Added statistic table options to Graphing Preferences dialog @RISK
DTS-302 Identify and Graph Outliers in Box Plots @RISK
DTS-377 Disable All Correlations During Simulations @RISK
DTS-383 Configure Two-Color Tornados @RISK
DTS-400 RiskOptimizer Graph to Compare Original vs Optimized Distribution @RISK
DTS-401 Calculate Joint Probabilities Using New Statistic Functions @RISK
DTS-411 Add appropriate error messages when attempting to correlate uncorrelatable functions @RISK
DTS-471 Increased Report Limits @RISK
DTS-481 Add Property Functions from the Insert Menu @RISK
DTS-499 Improved handling of manually deleted correlation matrices and copulas @RISK
DTS-512 Support for worksheet-level correlation names @RISK
DTS-606 Restore Insert Property Function Menu to be part of the Ribbon options @RISK
DTS-607 Enabled Multiple reports dialog configuration for models without simulation results @RISK
DTS-730 Select Report Outputs and Inputs across Multiple Worksheets @RISK
DTS-788 New Dynamic Welcome Screen Content @RISK
DTS-974 Allow loading values from Excel range directly into Percentile Defaults Dialog @RISK
DTS-1439 Model List and Results Summary Status Column Helps Identify Locked Inputs @RISK
DTS-720 Simplified activation process to only offer manual activation after automatic activation failure Licensing
DTS-381 New Classification Performance Measures Report NeuralTools

Fixes

DTS-11 Negative values are not shown correctly in sensitivity report table @RISK
DTS-12 Incorrect column headers in "Overlay Simulations" report table @RISK
DTS-13 Incorrect table values shown in sensitivity report @RISK
DTS-17 Copying worksheets between two workbooks containing correlations with the same name can confuse @RISK @RISK
DTS-18 Fit Manager blocks adding fit to non-active workbook @RISK
DTS-21 Scenario Setttings not properly handling -Infinity as a lower bound @RISK
DTS-23 XDK Sensitivity Report sometimes showing incorrect table @RISK
DTS-90 Compact Output Report does not fit on one Excel page @RISK
DTS-91 PDF Reports not showing Chinese characters @RISK
DTS-92 Report worksheets can have naming conflicts @RISK
DTS-118 Incorrect worksheet names for some scenario reports @RISK
DTS-133 Bad Summary Statistics and Detailed Statistics report titles when using multiple named simulations @RISK
DTS-144 Saving a scenario setting as defaullt that doesn't use percentiles doesn't work correctly @RISK
DTS-189 Incorrect filter minimum and maximum shown in detailed statistics report @RISK
DTS-267 Report graph images can sometimes be blurry @RISK
DTS-350 Remove @RISK Functions does not display a warning message when trying to remove functions from a protected workbook @RISK
DTS-372 Error after deleting columns with correlation matrix @RISK
DTS-412 Swapping in @RISK function with Excel in manual recalculation mode shows #NAME? errors @RISK
DTS-421 RISKOptimizer sometimes sends reports to the wrong workbook @RISK
DTS-422 Mouse wheel no longer works when RISKOptimizer reports are sent to Active Workbook @RISK
DTS-467 Recently simulated file links in Welcome Screen do not work if files are saved in OneDrive @RISK
DTS-469 Error clicking in empty header column in Copula Fit Results window @RISK
DTS-493 Error inside Model dialog after deleting correlation matrices @RISK
DTS-624 Compact output report delimiter values do not match Left X and Right X summary statistics values @RISK
DTS-634 Sensitivity Report with Regression Mapped Values uses incorrect number formatting @RISK
DTS-647 Non US-English regional settings causing RiskCompound issues @RISK
DTS-659 Opening models that prompt to update links sometimes interfere with loading saved simulation settings @RISK
DTS-660 Error simulating RiskSplice distributions that have internal distributions that use the implicit intersection '@' symbol @RISK
DTS-695 Define distribution overlay reference is not updated when referencing a distribution in another cell @RISK
DTS-696 Define Distribution Window distribution panel scrolled incorrectly after exiting Free-Edit mode @RISK
DTS-711 Overflow error when changing alt parameterization in Define Distribution Window @RISK
DTS-768 Added support for date variables to summary graphs @RISK
DTS-769 Allow summary graphs to be created with a single variable @RISK
DTS-783 Graph options dialog sometimes not displayed after showing the Excel cells selector @RISK
DTS-792 Distribution Artist: Remove Bar is missing from the right-click menu @RISK
DTS-798 Output Range: When copy pasting the name of an individual ouput the information from the
entire row is copied and pasted
@RISK
DTS-811 Specific large model either runs very slowly with Multiple CPUs @RISK
DTS-818 In Sensitivity Settings Dialog, removing selection for Must Change Statistic By doesn't update graph @RISK
DTS-905 Summary Trend and Summary Box Plot graphs do not retain currency formatting of inputs/outputs @RISK
DTS-918 External function calls inside RiskName field can cause crashes when opening a model @RISK
DTS-975 Error with Spanish regional settings and output with name defined using a disjoint range @RISK
DTS-976 Large customer model runs slowly with Multiple CPUs @RISK
DTS-979 Pressing the Esc-key while the mouse is down on window's title bar can cause VBA code execution to be interrupted @RISK
DTS-1026 Graphing Preferences Dialog BoxPlot tab has incorrect statistics names @RISK
DTS-1063 RiskLock doesn't return proper static value for Time Series functions @RISK
DTS-1064 Dragging and dropping between two Browse Result Windows can result in two curves showing the same output @RISK
DTS-1065 Copying and pasting sometimes works incorrectly inside the Define Correlation Dialog @RISK
DTS-1067 Linked fit that references a function name instead of a fit statistic fails @RISK
DTS-1068 Copying and pasting sometimes works incorrectly inside the Define Filters Dialog @RISK
DTS-1069 Copying and pasting sometimes works incorrectly inside the Scenario Settings Dialog @RISK
DTS-1143 Data Window display issues for large models @RISK
DTS-1256 Data Window's Iteration Step function crashes Excel with particular model @RISK
DTS-1296 Customer model cannot be Swapped in, message saying a formula couldn't be correctly parsed @RISK
DTS-1305 Improper license expiration messages from licenses borrowed from a network server @RISK
DTS-1328 Error message trying to edit a correlation matrix through Model Window @RISK
DTS-1329 Local help for some dialogs forced behind Excel window @RISK
DTS-1360 Iteration filter applied to statistic function causes crash if statistic functions update every iteration DTools;@RISK
DTS-1083 Diagnostic Utility is checking for incorrect VC++ runtimes Installer /
Deployment
DTS-1347 Repairing a license doesn't refresh the Server Manager window Licensing
DTS-349 Training large customer file leads to 'Application-defined or object-defined error" NeuralTools
DTS-531 Right-click option to select or deselect all variables in the Data Viewer is not working NeuralTools
DTS-993 Right-click context menu shows also with left click in Dataset Manager Dialog NeuralTools
DTS-536 "Invalid formula" message trying to simulate PrecisionTree influence diagram in @RISK PrecisionTree
DTS-786 Influence Diagram calculation ordering problems PrecisionTree
DTS-1362 @RISK Reports sent to Excel do not include graphs when PrecisionTree is also open. PrecisionTree
DTS-656 Problems with Pareto Charts with large number of cateogories StatTools
DTS-725 Same variable can be selected as Cat and Val for Pareto Charts StatTools
DTS-1071 Inputs defined with RiskName don't display names correctly in tornado charts and spider graphs TopRank

Release 8.0.1 - July, 2020

Highlights

All Products: Dynamic Array Support

Some versions of Office 365 now include support for a new type of array formulas known as “dynamic arrays”. This resulted in changes to the syntax of some other non-array formulas: users will notice the “@” sign in some formulas, where it did not appear before. While TopRank itself does not make use of dynamic arrays, it has its own custom cell functions, and their syntax was affected by the introduction of dynamic arrays. This version has been made compatible with the new syntax.

PrecisionTree: Link to BigPicture Removed

The BigPicture add-in has been discontinued. The “View in BigPicture” ribbon command has been removed in this version.

TopRank: Running TopRank and @RISK at the Same Time

Previous versions of TopRank would sometimes require special reconfiguration of @RISK so the two add-ins could both be loaded at the same time. This requirement has been removed in this version.

Enhancements

DTS-370 Implemented ability to right-click on tornado bar to hide it @RISK
DTS-409 Minor formatting change in group separator rows in Detailed Statistics Report @RISK
DTS-433 Graph View of Correlation Definition Window displays coefficients for each cell @RISK

Fixes

DTS-420 Repair button improperly enabled for broken and expired licenses in Palisade Server Manager Licensing
DTS-364 Some permanent licenses incorrectly marked as expiring in Palisade Server Manager Licensing
DTS-127 Clicking on parameter label in Define Distribution Window leads to error @RISK
DTS-191 Right click on Category row in Results Summary window generates error message @RISK
DTS-199 Export to Excel from Data Window when Iterations is set to Auto generates 'Unable to generate report' error @RISK
DTS-236 Auto Save notification links to incorrect help page. @RISK
DTS-242 Graph font size problems with large monitors with large DPI scaling @RISK
DTS-262 Incorrect Filter Minimum and Maximum shown in Detailed Statistics Report @RISK
DTS-263 Sensitivity Report shows incorrect sensitivity calculation table in some situations @RISK
DTS-264 Compact Output report to Excel does not fit on one page @RISK
DTS-265 Incorrect Tornado bar labels for inputs containing RiskName property function that use cell references across multiple worksheets @RISK
DTS-273 Browse Results window too wide at 200% DPI scaling @RISK
DTS-296 Dragging graphs from Multivariate Data Viewer sometimes triggers error @RISK
DTS-322 Exports from the Data Window of very large data sets can generate 'Unable to copy cells.' error. @RISK
DTS-347 Knowlege Base item on the Resource menu links to incorrect web page @RISK
DTS-438 Deleted Predefined Distribution still shows on the Define Distribution Favorites list @RISK
DTS-474 File with copula information fails to open @RISK
DTS-511 Problems opening Define Correlation dialogs with inputs across multiple workbooks @RISK
DTS-535 Problem when two workbooks have correlation matrices with the same name @RISK
DTS-621 Bar Shading in Change in Output Tornado Graphs May Be Reversed @RISK
DTS-623 RiskName with multiple cells references for Alt distributions can cause errors @RISK
DTS-624 Compact output report delimiter values do not match Left X and Right X summary statistics values @RISK
DTS-75 Performing multiple exports from the Results Summary Window can cause Excel to close unexpectedly @RISK
DTS-456 Application Settings dropdown menu options can not be selected using mouse TopRank

Previous Versions

@RISK Release Notes (versions 5.X - 7.X)

Evolver Release Notes (versions 5.X - 7.X)

NeuralTools Release Notes (versions 5.X - 7.X)

PrecisionTree Release Notes (versions 5.X - 7.X)

StatTools Release Notes (versions 5.X - 7.X)

TopRank Release Notes (versions 5.X - 7.X)
